Three Project Management Metrics Agencies Need to Measure
As a marketing agency operator seeking productivity improvements, you’ve likely invested in project management tools like ClickUp or Monday.com. However, measuring whether these systems truly drive efficiency requires tracking specific metrics. (These three metrics complement the broader set of agency KPIs you should be tracking across your business.)
ZenPilot focuses on three critical measurements to evaluate team planning and execution capability. These metrics work best when tracked inside a well-structured project management tool with consistent habits across the team:
- Compliance Ratio - Team capacity utilization effectiveness
- Completed Ratio - Execution quality on planned work
- Velocity Ratio - Alignment between planning and actual output
Building Healthy Team Habits to Boost Agency Performance
Success requires establishing organizational habits at every level: executive leadership modeling accountability, account and project managers coordinating planning and deployment, and individual contributors executing assigned work.
The foundation rests on a simple principle: “healthier habits = healthier data = better decisions.”
Better Inputs = Better Outputs
Every task requires three essential components:
- Due Date - Completion deadline
- Time Estimate - Predicted duration (accurate estimates depend on solid time tracking habits)
- Single Assignee - One responsible person
Understanding Work in Your Project Management System

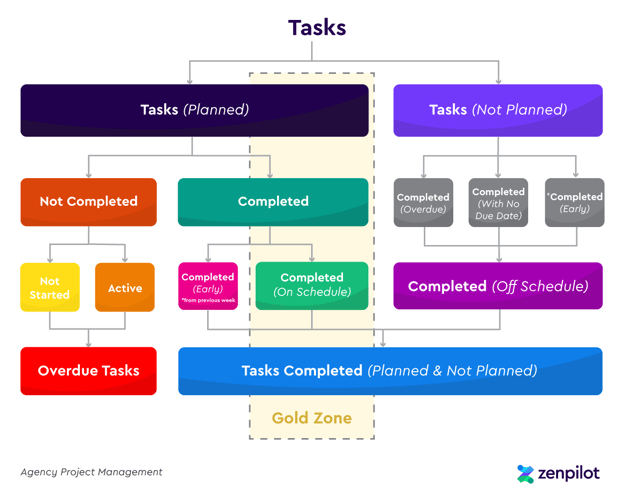

Task categorization enables meaningful analysis. Tasks fall into planned versus unplanned categories, with completion status tracked as on-schedule, early, overdue, or without due dates.
The ideal state concentrates work in the “Gold Zone” - tasks that are both planned and completed on schedule, maximizing forecasting accuracy.
Performance Metrics Calculations
1. Compliance Ratio
Formula: Tasks Completed (On Schedule) / Total Tasks Completed
This measures how well teams execute scheduled work. A team closing 736 total tasks with 425 completed on schedule yields a 0.58 ratio, indicating room for scheduling improvement.
2. Completed Ratio
Formula: Tasks Completed (On Schedule) / Total Planned Tasks
This indicates execution against planning. If 933 tasks were scheduled but only 425 completed on schedule, the ratio is 0.46, suggesting planning-execution misalignment.
3. Velocity Ratio
Formula: Total Tasks Closed / Total Planned Tasks
This reveals capacity versus planning. Completing 736 tasks against 933 planned tasks yields 0.79, indicating the team handled slightly less volume than scheduled.
Overall Efficiency Score
The weighted formula combines all three metrics:
Score = (Completed Ratio x 0.35) + (Compliance Ratio x 0.35) + Velocity Coefficient
For the velocity component:
- If ratio > 1: Apply (-1 x (ratio - 1) x 0.3) + 0.3
- If ratio < 1: Apply ratio x 0.3
Scores approaching 1.0 indicate strong forecasting capability and capacity confidence for new projects.
Three Scenario Analysis
Scenario 1: High completion (1.00) with extra capacity (1.30 velocity) signals readiness for additional work, despite some scheduling variance.
Scenario 2: Low completion (0.30) with lower velocity (0.80) suggests project managers should reduce assignments and investigate unplanned task sources.
Scenario 3: Strong completion (0.85) with moderate velocity (1.00) represents solid forecasting needing minor refinement on off-schedule task reduction.
Achieving Operational Clarity
ZenPilot’s 1-3-5 Formula emphasizes that true clarity requires:
- Properly structured project management hierarchies
- Automated workflow solutions
- Consistent reporting and analysis
- Team accountability through dedicated champions
The organization must continuously optimize workflows, automate repetitive processes, and improve forecasting through data-driven decisions. ClickUp Dashboards make it easy to visualize these metrics in real time, and combining them with workload and capacity views gives you the full picture of team health.
